Excel Air Quality Monitoring Dashboard-As of July 31, 2026


Excel Air Quality Monitoring Dashboard-As of July 31, 2026

The monthly Environmental Monitoring Reports may be found on the BPCA Resiliency website. Click HERE to open a new browser window.


To report concerns or ask questions related to the Air Quality Monitoring, click HERE to initiate an email to BPCA.

Gateway Tenant Association

Independent Environmental Monitoring Dashboard

Excel Environmental Resources review of the North/West Battery Park City Resiliency Project

Latest Excel reports reviewed: April through July 2026

BPCA retained Excel Environmental Resources as its independent environmental monitor. Enovate Engineering, the contractor’s monitoring subcontractor, operates the project’s Community Air Monitoring Plan (CAMP) monitoring system. This dashboard translates Excel’s independent findings into plain language and maintains a rolling record as each new monthly report is released.

Latest Month: July 2026 — What Residents Need to Know Now

WatchExcel PM events49*Excel separated 49 non-wildfire PM Action Level events from more than 300 alerts attributed to Canadian wildfire smoke.
ConcernLevel 2 events25*11 PM10 + 14 PM2.5 Level 2 events in Excel's non-wildfire event set.
Regional eventWildfire-related alerts>300Excel attributed more than 300 July alerts to regional Canadian wildfire smoke rather than project activity.
Reassuring24-hour PM exceedances0Enovate reported no construction-related 24-hour PM exceedances.
ReassuringVOC Action Level events0No VOC Action Level events were reported in July.
Network sizeActive monitor IDs at month-end2325 distinct IDs appeared during July; two Reach 6 Albany monitors ended July 7 and two Reach 2 monitors were added late month.
WatchDocumented power availability97.2%GTA reconstructed 437 documented power-disconnection monitor-hours in July; this does not measure all causes of downtime.
More oversightExcel site visits5July 2, 7, 17, 24 & 29 — the highest onsite inspection frequency to date.
ConcernMonitoring-integrity incidents2Excel documented an obstructed Reach 7 monitor and Reach 2 work occurring before apparent monitors were in place.
WatchNoise reviewStill unavailableExcel states that, as of July, Turner/Enovate still had not provided noise data or noise reports.
July produced the strongest monitoring-integrity findings yet: a Reach 7 monitor was found with its dust and VOC intakes blocked by plastic cups, and Excel twice observed Reach 2 utility trenching with no apparent air monitors in place.

Excel also continued to report multiple Level 1 events without adequate dust mitigation and Level 2 events where work was not stopped or controls were not re-evaluated as required by the CAMP. July's Canadian wildfire smoke created an additional attribution challenge, making transparent event classification especially important.

Important July count note: Excel reports 49 non-wildfire PM Action Level events and more than 300 wildfire-related alerts. Enovate specifically enumerates 62 PM events outside its broad “numerous wildfire” statements. The 13-event difference corresponds to specifically listed Enovate events dated July 15–20, including some Enovate individually attributes to construction. GTA therefore treats July event-count reconciliation as an open QA issue rather than silently choosing one total. Definitions & explanations ↓
July's key independent finding: Excel found both a physical obstruction of an active monitoring unit and active Reach 2 work before apparent air monitors were in place, while also repeating its concern that required CAMP mitigation and stop-work procedures were not consistently followed.
Rolling 6-Month SnapshotView detailsHide details

This section will always show the six most recent reporting months using the same resident-facing measures. Excel is BPCA’s independent monitor; Enovate operates the contractor’s CAMP monitoring system. As new Excel reports are released, the cards will update and older months will move to the archive.

Who is who: Excel is BPCA’s independent environmental monitor. Enovate is the contractor’s environmental monitoring subcontractor and operates the project’s CAMP monitoring system.
April 2026
Excel — Independent Monitor
PM events
46
Enovate — Contractor Monitor
PM events
47
24-hour PM exceedances 0Reassuring
VOC Action Level events 0Reassuring
Active monitor IDs 15*Appendix count
Documented power availability 100.0%*Defined active periods
Independent noise reviewNot availableWatch
Public reporting delay151 daysConcern
May 2026
Excel — Independent Monitor
PM events
139
Enovate — Contractor Monitor
PM events
100
24-hour PM exceedances 0Reassuring
VOC Action Level events 0Reassuring
Active monitor IDs 19*Appendix count
Documented power availability 93.9%Concern
Excel site inspections1 (5/15)More oversight
Independent noise reviewNot availableWatch
Public reporting delay121 daysConcern
May report QA note: Excel’s final May report contains internal count and month-label inconsistencies. This dashboard uses the totals stated in Excel’s executive summary.
June 2026
Excel — Independent Monitor
PM events
193
Enovate — Contractor Monitor
PM events
194
24-hour PM exceedances 0Reassuring
VOC Action Level events 0Reassuring
Active monitor IDs 21Network size
Documented power availability 98.0%Improving
Excel site inspections2 (6/5, 6/26)More oversight
Independent noise reviewReview underwayWatch
July 2026
Excel — Independent Monitor
PM events
49*+ >300 wildfire alerts
Enovate — Contractor Monitor
PM events
62†Count QA
24-hour PM exceedances0Reassuring
VOC Action Level events0Reassuring
Active monitor IDs23Month-end
Documented power availability97.2%437 hrs disconnected
Excel site inspections5 (7/2, 7/7, 7/17, 7/24, 7/29)More oversight
Independent noise reviewData not providedConcern
Public reporting delayReport date blankQA / transparency
August 2026
Excel — Independent Monitor
PM events
Awaiting report
Enovate — Contractor Monitor
PM events
—
24-hour PM exceedances —
VOC Action Level events —
Active monitor IDs —
Documented power availability —
Independent noise review—
September 2026
Excel — Independent Monitor
PM events
Awaiting report
Enovate — Contractor Monitor
PM events
—
24-hour PM exceedances —
VOC Action Level events —
Active monitor IDs —
Documented power availability —
Independent noise review—
Noise note: Excel reported no access to noise-monitoring data in April or May, said it was reviewing Enovate noise reports in June, and then stated that as of July it still had not been provided noise data or noise reports by Turner or Enovate. “Not available” therefore does not mean zero noise alerts.
PM count comparison: Excel and Enovate review the same underlying Aeroqual network, but their published monthly totals do not always match. April and June differ slightly; May differs materially. July requires special handling because wildfire smoke produced more than 300 regional alerts. Excel reports 49 non-wildfire PM events, while Enovate specifically enumerates 62 PM events outside its broad “numerous wildfire” statements. The 13-event difference corresponds to July 15–20; some of those Enovate entries are individually attributed to construction. GTA shows both totals and flags the discrepancy for reconciliation.
Documented power availability: GTA reconstructs expected monitor-hours from Enovate’s appendix report periods and subtracts intervals Enovate explicitly identifies as “disconnected from power.” This measures documented power availability only; it does not establish total operational uptime, calibration validity, communications status, correct siting, or meaningful upwind/downwind coverage. July: GTA identified 437 documented power-disconnection monitor-hours across the network, corresponding to approximately 97.2% documented power availability over the reconstructed active periods. Reach 7 alone accounts for approximately 250 of those hours.

*Monitor-count QA note: July involved 25 distinct monitor IDs during the month, but 23 were active at month-end because AM-11 and AM-12 at Reach 6 (Albany St) ended July 7 while AM-30A and AM-31A were added to Reach 2 late in the month.

Reporting-delay context: April–June Excel reports were released months after their reporting periods. For July, the report’s “REPORT DATE” field is blank, so the dashboard does not invent a delay figure. Enovate’s separate July contractor report is dated August 28, 2026.
Independent Field OversightView detailsHide details

April — Remote Review Only

Excel reported that it was not yet fully onboarded, conducted no onsite inspections, and did not yet have access to noise data.

May — First Site Visit

Excel conducted one site visit on May 15. It did not observe visible dust during the visit, although remote monitoring showed PM events in Reach 1 and Reach 5 that day.

June — Two Site Visits

Excel inspected on June 5 and June 26. On June 5, it observed visible dust in Reach 5 and said additional water spraying began after Excel raised the concern.

July — Five Site Visits & Two Major Integrity Findings

Excel inspected on July 2, 7, 17, 24 and 29. On July 7, Excel found plastic cups covering AM-02's dust and VOC intakes in Reach 7 and characterized the unit as having been tampered with. On July 24 and 29, Excel observed utility trenching in Reach 2 with no apparent air monitors in place and reminded the project team that CAMP monitors must be installed and operational before work begins.

What “Independent” Means Here

Excel is primarily overseeing Enovate’s contractor-operated network. Excel’s own direct measurements were limited to periodic field inspections rather than a separate 24/7 independent monitoring network. Excel’s scope also indicates that event causes may be relayed as determined by the BPCA project team, so residents should distinguish independent review from fully independent cause attribution.

Monitoring Integrity & CoverageView detailsHide details

July — Event Count / Wildfire Classification Needs Reconciliation

Excel reports more than 300 wildfire-related alerts plus 49 non-wildfire PM events. Enovate specifically enumerates 62 PM events outside its broad “numerous wildfire” statements. The 13-event difference corresponds to specifically listed events dated July 15–20, and some of those Enovate entries are individually attributed to construction. GTA recommends an event-level reconciliation rather than a blanket date-based exclusion.

July — Reach 2 Work Before Apparent Monitoring Was In Place

Excel documented utility trenching in Reach 2 on both July 24 and July 29 with no apparent air monitors in place and stated that work cannot begin before CAMP monitors are installed and operational. Enovate says AM-30A and AM-31A were installed July 30, while its appendix data report for Reach 2 begins July 29 at 08:00. That timing discrepancy should be reconciled with the actual GPS/location and device-history records.

July — Obstructed Monitor / Apparent Tampering

Excel found plastic cups covering the dust and VOC intakes on AM-02 in Reach 7 on July 7. The cups were removed after Excel raised the issue. The reports do not state how long the intakes had been obstructed, whether affected data were invalidated, whether an alert or data-quality flag was generated, who placed the cups, or what audit/inspection controls were added afterward.

Actual Monitor Locations Are Not Always Clear

The reports use a mixture of design and apparent as-built monitoring plans, even though the underlying plans state that monitor locations may be adjusted in the field. A dated, “as-operated” monthly map is not provided.

Reach 5E / Reach 6A North

June acknowledges micropile drilling in Reach 5E, but the inspection narratives do not separately document the Gateway-adjacent work area, reconcile the Reach 5E / Reach 6A North designation, or clearly identify which monitors served that work.

Monitor Outages

Enovate reports multiple monitor power disconnections, but Excel’s reports do not provide a resident-friendly monitor-by-monitor uptime and outage ledger. Future reporting should identify the monitor ID, cause and duration of each outage, whether another monitor provided adequate redundancy, whether the outage affected upwind/downwind site-contribution calculations, and when full monitoring was restored.

Negative Readings

April notes negative rolling-average readings attributed to automatic calibration overcorrection. Excel says they should be treated as zero but does not quantify how often this occurred.

Power Availability Trend

Based on GTA’s reconstruction of Enovate appendix data, documented power availability was approximately 93.9% in May, 98.0% in June, and 97.2% in July. July contains approximately 437 documented power-disconnection monitor-hours, including about 250 hours in Reach 7. These figures capture only periods Enovate explicitly labels as disconnected from power and do not include other causes of unavailable or invalid monitoring.

Low-Wind Conditions Can Limit Site Attribution

Enovate states that when wind speed falls below 1 mph, the downwind monitor is considered undetermined and site contribution cannot be calculated for that interval. GTA’s review of Enovate’s published wind-rose summaries found very low-wind conditions were common. In June, 21 of 34 wind-rose reporting blocks (62%) showed calm and/or sub-2 mph conditions for at least half of the reporting period.

Because Enovate groups winds below 2 mph rather than separately reporting the exact time below 1 mph, the percentage of intervals in which site contribution was unavailable cannot be determined from the published reports.

Important: The 62% figure is a low-wind screening indicator, not a measure of the percentage of time site contribution was unavailable.

Corrective Actions & AccountabilityView detailsHide details
Excel’s July report escalates the accountability concern: it documents a physically obstructed monitor, work underway before apparent CAMP monitors were installed, and continued instances where required Level 1 mitigation or Level 2 stop-work/BMP re-evaluation did not occur. The reports still do not provide a resident-facing closure register showing when each issue was corrected, independently verified, and closed.

What the Reports Do Provide

Excel identifies events where stronger mitigation, work stoppage, BMP re-evaluation, or other action should have occurred.

What Is Missing

A resident-friendly corrective-action register: date, issue, required response, who was notified, what was done, when Excel verified it, and whether the item is open or closed.

July Corrective Recommendations

Excel specifically recommended: ensure all plan-specified monitors are installed and operational before work begins; inspect sensors and intakes each day for obstruction; immediately rectify and document any issue; consistently follow CAMP stop-work requirements; and improve preventive wetting/covering of exposed soil and stockpiles.

GTA Watch List / Open QuestionsView detailsHide details

1. Reconstruct Reach 2 Monitoring Coverage

Provide the native Aeroqual/OneView device and location history for Reach 2, including the exact installation/activation times for AM-30A and AM-31A, GPS coordinates, data timestamps, and an explanation for why Enovate's appendix report begins July 29 at 08:00 while its narrative says the monitors were installed July 30 and Excel observed no apparent units on July 29.

2. Investigate the AM-02 Obstruction / Tampering Event

Determine how long AM-02's PM and VOC intakes were covered, who placed the cups, whether data from the affected period were flagged or invalidated, whether OneView generated sensor/data-quality alerts, and what physical/audit controls were implemented afterward.

3. Document Every Level 2 Stop-Work Response

For each Level 2 event, identify whether work actually stopped, what BMPs were re-evaluated, when readings returned below threshold, and when work resumed. Excel again states in July that these procedures were not consistently followed.

4. Publish As-Operated Monitor Maps, GPS History & Downtime

Provide dated actual monitor locations—not only design locations—plus installation, relocation and removal times, GPS/location history, and all periods of unavailable or invalid monitoring. July makes this especially important.

5. Publish Power / Health / Alert Logs

For each documented power disconnection, provide low-voltage warnings, offline alerts, recipients, response times, restoration times and whether local data were recovered. July contains about 437 documented power-disconnection monitor-hours.

6. Reconcile July Wildfire and Project Event Counts

Reconcile Excel's 49 non-wildfire PM events with Enovate's 62 specifically enumerated events outside its broad wildfire statements, particularly the 13 events dated July 15–20 and the cause assigned to each.

7. Publish Site-Contribution Availability

Report, by Reach and month, the percentage of valid 15-minute intervals in which wind conditions and monitor geometry allowed a meaningful upwind/downwind site-contribution calculation, including intervals excluded for wind below 1 mph.

8. Complete Independent Noise Oversight

Explain why Excel still had not received noise data or reports as of July, when full access began, whether April–July will be reviewed retroactively, and how noise alerts/corrective actions will be reported.

9. Track Corrective Actions to Closure

Publish an event-by-event corrective-action register showing issue, required response, party notified, action taken, Excel verification date, and open/closed status.

10. Clarify Reach 5E / Reach 6A North Coverage

Explain which monitors covered Gateway-adjacent work, their actual coordinates and dates, how Reach 5E and Reach 6A North terminology should be reconciled, and whether the configuration provided meaningful receptor and upwind/downwind coverage.

Definitions & How to Read This DashboardView detailsHide details

This reference section explains the technical shorthand used above. Linked terms throughout the dashboard jump here for readers who want more detail.

Community Air Monitoring Plan (CAMP)

The project's CAMP establishes how construction-related air monitoring is performed and sets short-term response thresholds known as Action Levels. The purpose is to trigger protective action during construction when particulate levels rise.

↑ Back to top

PM / Particulate Matter

PM means particulate matter: tiny airborne solid particles and liquid droplets. The dashboard counts short-term PM Action Level events reported by the project monitors; these are not automatically the same thing as violations of longer-term regulatory air-quality standards.

↑ Back to top

PM10

PM10 refers to inhalable particles with aerodynamic diameters generally 10 micrometers or smaller. Construction dust can contribute to PM10, which is why the CAMP monitors it separately.

↑ Back to top

PM2.5

PM2.5 refers to fine particles with aerodynamic diameters generally 2.5 micrometers or smaller. These particles are smaller than PM10 and are monitored under their own CAMP thresholds.

↑ Back to top

Action Level 1

Level 1 is the lower CAMP response threshold. When construction-related particulate levels reach this level, the plan calls for additional or re-evaluated dust-control measures while work may continue only under the applicable CAMP conditions.

↑ Back to top

Action Level 2

Level 2 is the higher CAMP response threshold. After required suppression efforts, an applicable Level 2 condition requires work to stop, controls to be re-evaluated, and work to resume only after particulate conditions are reduced below the applicable threshold and visible migration is controlled.

Why GTA highlights it: Level 2 events provide an especially important test of whether the project's required protective response was followed.

↑ Back to top

Site Contribution / Upwind & Downwind

The contractor compares upwind and downwind readings to estimate the portion of particulate levels that may be attributable to construction. Wind direction is therefore central to the calculation. When wind is too light to determine a downwind station, the project may be unable to calculate a site-contribution value even though raw monitor readings still exist.

Monitor-siting concern: In several project reaches, only two fixed air monitors appear to be deployed, and in some locations those monitors are oriented generally north–south along the waterfront. When winds move west-to-east across the Hudson River waterfront, a fixed north–south pair may not consistently function as a true upwind/downwind pair and both monitors may be partly crosswind to a construction plume. This does not mean the monitors provide no useful information, but it raises a reasonable question about whether the fixed locations consistently provide the intended upwind/downwind comparison and adequately capture localized emissions near nearby receptors.

GTA has therefore asked BPCA to explain the siting rationale for each reach and to provide dated, as-operated monitor locations together with wind direction, monitor relocations, outages, and any supplemental or mobile monitoring used when fixed locations do not create a meaningful upwind/downwind comparison.

The dashboard does not characterize west-to-east winds as the prevailing condition for all periods unless supported by the project's own meteorological data. The concern applies specifically during periods when wind direction makes a north–south monitor pair crosswind rather than upwind/downwind.

↑ Back to top

Low-wind reporting limitation: Enovate’s wind-rose summaries group conditions into “calm” and “<2 mph” categories, while the CAMP site-contribution cutoff is <1 mph. As a result, the published reports do not provide enough detail to calculate the exact percentage of intervals when site contribution was unavailable because of low wind.

Excel Site Inspection

A site inspection is an onsite visit by Excel, BPCA's independent monitor. Excel also reviews the contractor's monitoring data remotely. A site-inspection count therefore should not be read as the number of days environmental monitoring occurred; the contractor-operated monitors run separately.

↑ Back to top

Noise Alerts / Noise Review

This dashboard reports noise information only when Excel's monthly reports provide enough information to do so. Excel reported no noise-monitoring access in April or May, said it was reviewing noise reports in June, and stated that as of July it still had not been provided noise data or noise reports by Turner or Enovate. “Not available” does not mean zero noise events.

↑ Back to top

Public Reporting Delay

The reporting-delay figure is normally the number of days from the end of the reporting month to the date shown on Excel's public monthly report. July's Excel report leaves the REPORT DATE field blank, so GTA does not invent a July delay figure.

↑ Back to top

Where Is the Work? Understanding the Project Reaches

The project is divided into numbered construction areas called Reaches. The visual below is more intuitive for community use because it shows the full Battery Park City project alignment and all seven reaches.

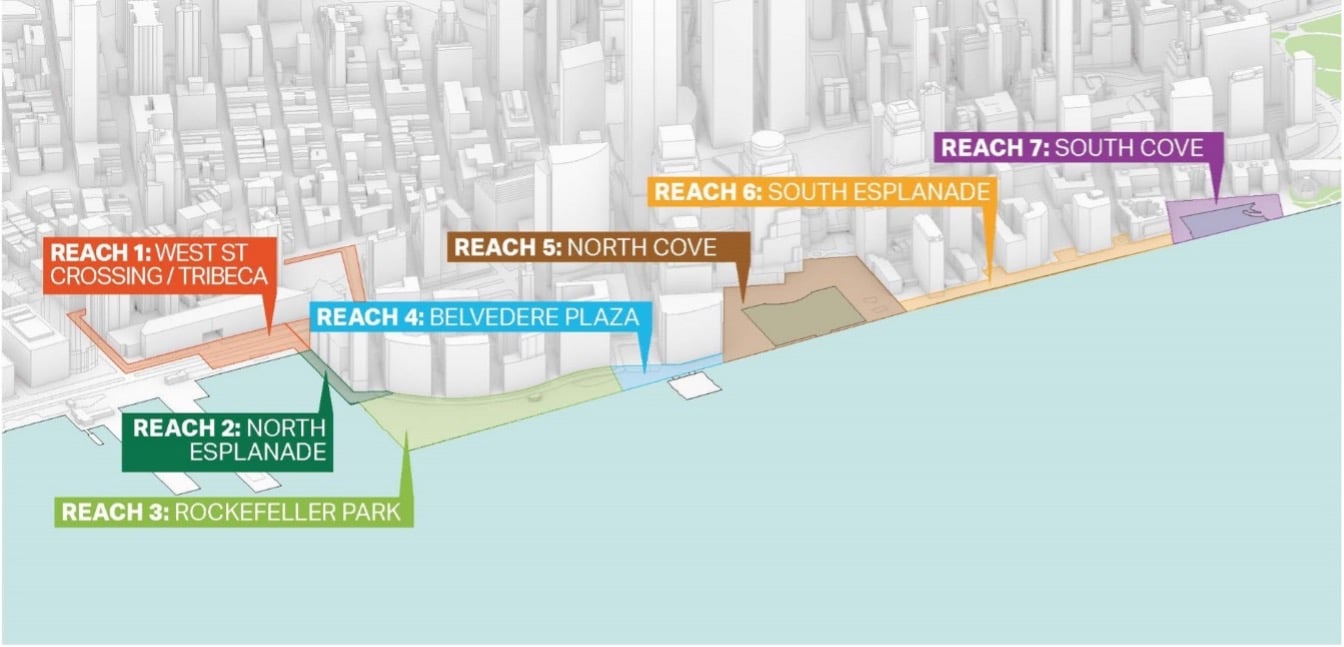

Overview image showing Reaches 1 through 7 along Battery Park City, including Reach 1 West Street Crossing Tribeca, Reach 2 North Esplanade, Reach 3 Rockefeller Park, Reach 4 Belvedere Plaza, Reach 5 North Cove, Reach 6 South Esplanade, and Reach 7 South Cove.
Community-facing overview of the project reaches. Image is used here as an orientation aid and should not be treated as a precise engineering boundary map.

Why this matters: environmental-monitoring results, monitor locations, outages, work activities and Excel observations are often reported by Reach rather than by familiar building, park or street name.

  • Reach 1 — West Street Crossing / Tribeca
  • Reach 2 — North Esplanade
  • Reach 3 — Rockefeller Park
  • Reach 4 — Belvedere Plaza
  • Reach 5 — North Cove
  • Reach 6 — South Esplanade
  • Reach 7 — South Cove

What the Excel reports now cover: by July, Excel reported monitoring activity across all seven project reaches. July also exposed an important coverage issue in Reach 2, where Excel observed utility trenching on July 24 and 29 with no apparent air monitors in place.

Reach 5E / Reach 6A North: the Gateway-adjacent area deserves particular care in interpreting the reports. Excel’s June work summary identifies micropile drilling in Reach 5E, while other project materials and community discussion also refer to the nearby area as Reach 6A North. The dashboard flags this as a monitoring-documentation issue rather than silently treating the names as interchangeable.

Resident-facing recommendation: future independent reports should include a dated “as-operated” map showing the actual location of every active air, noise and vibration monitor, along with installation, relocation, removal and outage dates.

↑ Back to top
Important: CAMP Action Levels are short-term project response thresholds. A reported Action Level event should not automatically be described as a regulatory air-quality violation or as evidence, by itself, of a health impact.

Source: Excel Environmental Resources Independent Environmental Monitoring Monthly Reports Nos. 1–4 for April, May, June and July 2026, prepared for the Battery Park City Authority's North/West Battery Park City Resiliency Project. Comparison figures also reference the corresponding Enovate Community Air Quality Monitoring reports.

Methodology note: GTA preserves source differences rather than silently reconciling them. July is especially complex because regional Canadian wildfire smoke produced more than 300 alerts. Excel reports 49 non-wildfire PM events; Enovate specifically enumerates 62 PM events outside its broad “numerous wildfire” statements. GTA therefore treats July's event classification as an open reconciliation item.

Important note: Short-term Action Level events are project-response thresholds and should not be interpreted as equivalent to sustained 24-hour regulatory exceedances.

Dashboard purpose: GTA summarizes technical monitoring information in plain English for local residents. This dashboard does not replace the underlying Excel or Enovate reports.
